Building Renovation Updates

Chemistry and Chemistry Annex Renovations

Project Schedule

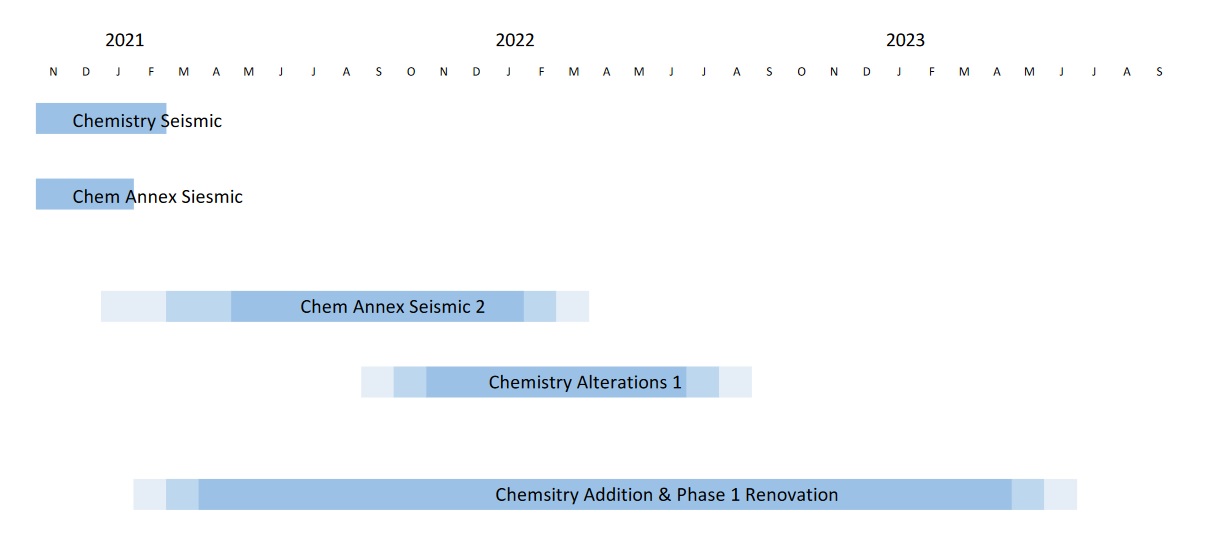

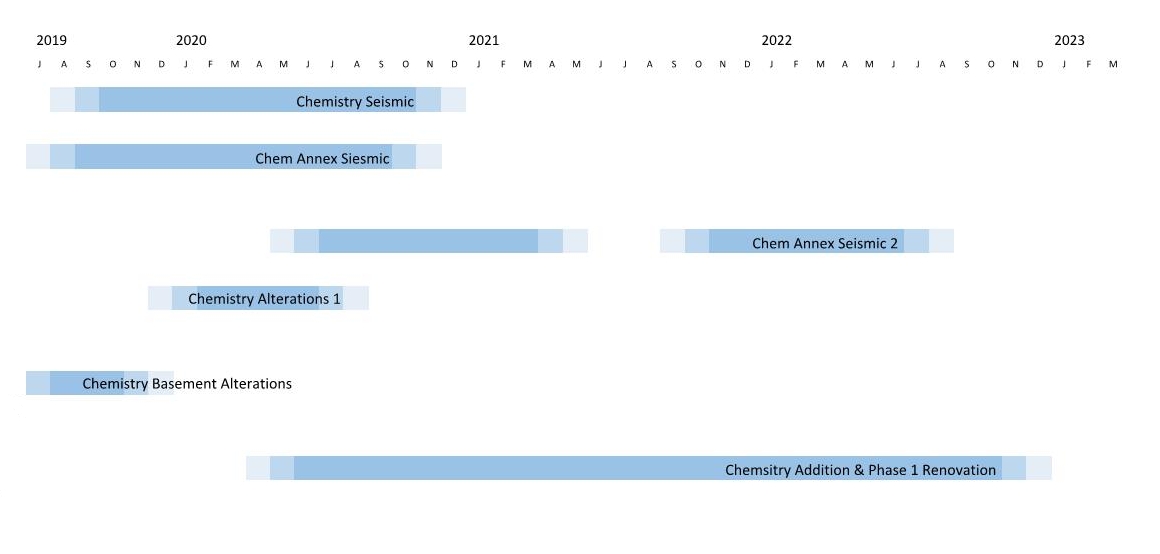

Chemistry_Renovation_Timeline_01252021



Site Plan of Chem



Project Description

Chemistry Seismic - In Construction
Structural corrections to the foundation and exterior walls and accessibility improvements.

Chem Annex Seismic - In Construction
Structural corrections to the foundation, exterior wall and interior columns (4th and 5th floors), and accessibility improvements.

Chem Annex Seismic 2 - In Construction Documents Phase
Seismic corrections to interior columns (Basement, 1st, 2nd, and 3rd floors).

Chemistry Alterations 1 - In Design Phase
Consolidation and alteration of existing receiving and store room space, glass shop, and office and storage space.

Chemistry Addition & Phase 1 Renovation - In Construction Documents Phase
Renovation of a portion of the 1st floor of Chemistry, a new 25,000 sf addition with new lab and office space, and improvements to primary building exhaust and electrical building systems.
